Surgical Guide Planning and Design Outsourcing
Surgical guide planning and design outsourcing is not simply the transfer of CBCT, STL, or implant data to an external team in exchange for a guide file. It is the integration of an external capability into an existing implant workflow—from restorative intent and implant planning through guide design, clinical approval, fabrication handoff, and final execution.
The key question is therefore not only whether a provider can produce a technically correct STL. It is whether that external capability can enter the workflow without weakening clinical intent, decision authority, design judgment, approval control, or downstream responsibility.
Reliable outsourcing depends on five things being clear from the beginning: scope, usable case context, design responsibility, approval boundaries, and handoff.
What Surgical Guide Planning and Design Actually Do in the Implant Workflow
Planning and guide design belong to the same guided implant workflow, but they solve different problems.
Implant planning defines the intended implant position within anatomical, restorative, and clinical constraints. Surgical guide design then converts the approved plan into geometry that can be fabricated, seated, and used within the intended guided surgery protocol.
Understanding that distinction matters when outsourcing because the two stages do not carry the same responsibility.
Start With the Final Restoration, Not the Guide

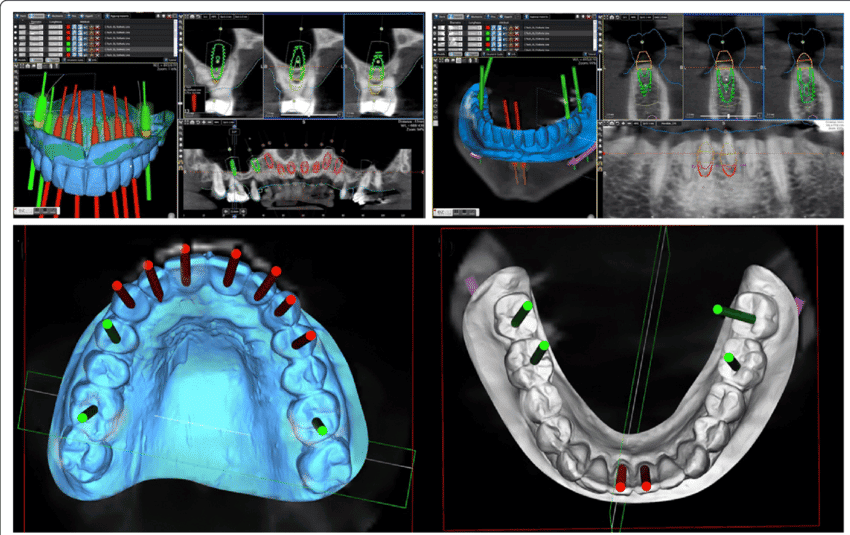

Implant planning should begin with the restorative objective rather than with the guide itself.
Planned tooth position, prosthetic space, emergence requirements, occlusal relationships, and the intended restoration help define where an implant should ideally be positioned. Those objectives must still be reconciled with bone availability, anatomical structures, and other clinical constraints by the responsible clinician.
For an external planning team, this means CBCT/DICOM data should not be treated as an isolated source of implant coordinates. Surface scans, restorative information, and treatment objectives provide the context needed to understand what the planned implant position is intended to support.
A team that understands only the requested coordinate may be able to execute software operations. A team that understands the restorative context is better positioned to recognize when important information is missing or when clarification is required before the plan moves forward.

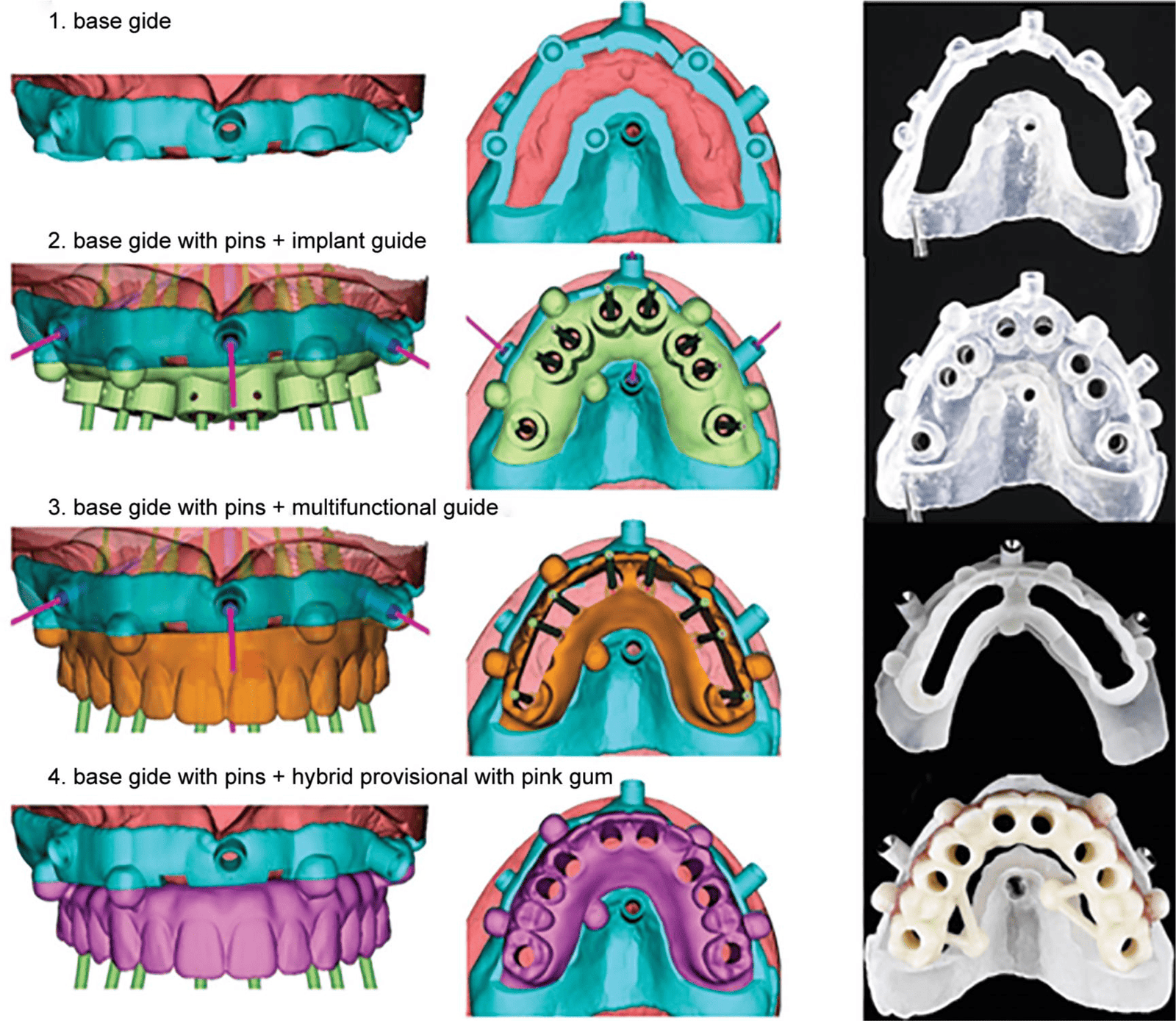

A Surgical Guide Transfers an Approved Plan
Once the implant position has been planned and clinically approved, the function of the surgical guide changes.
The guide does not decide where the implant should go. It transfers the approved position into the surgical procedure.
Depending on the protocol, the guide may control only part of the osteotomy sequence or may support a more fully guided workflow. The exact level of guidance can vary, but the responsibility boundary remains important:
Planning determines the intended target. Guide design protects the design-dependent part of transferring that target.
A well-designed guide cannot make an unsuitable implant plan suitable, and guide design does not control every source of clinical deviation.
For a deeper discussion of how planning, registration, support, guidance, fabrication, and clinical seating affect transfer accuracy, see How to Improve Surgical Guide Accuracy.

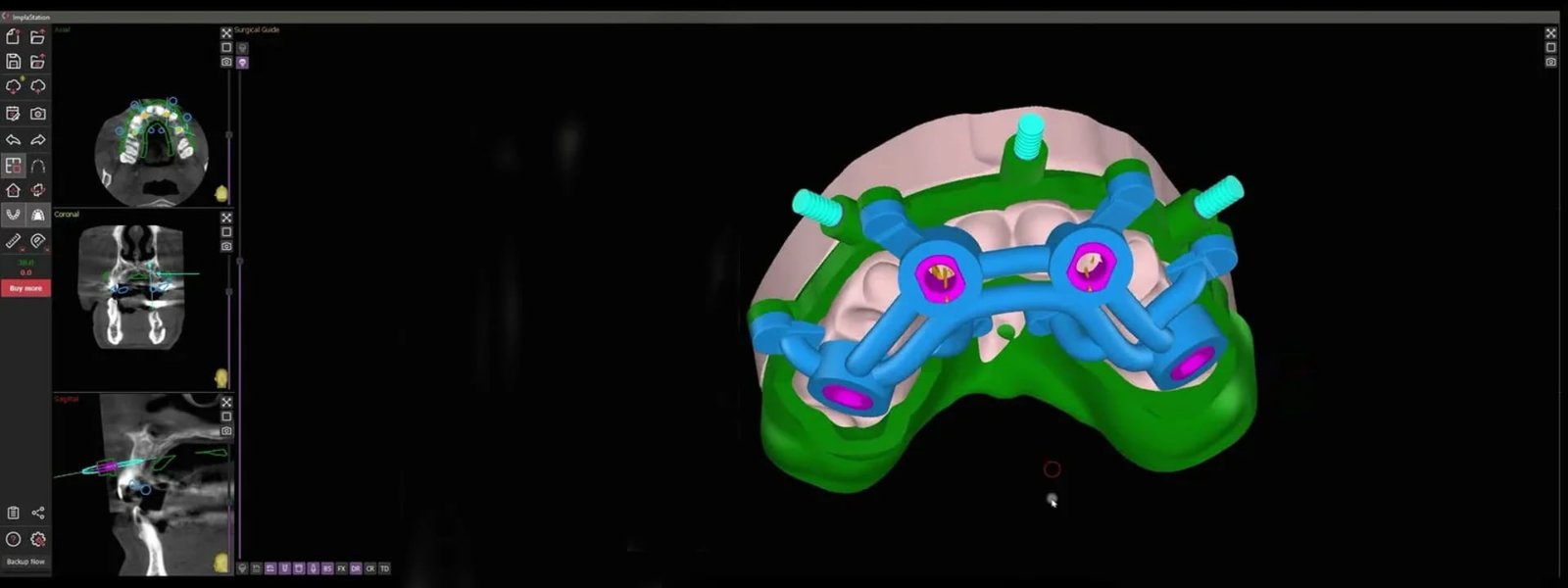

Surgical Guide Design Is a Judgment Task, Not Just CAD Execution
Surgical guide design must make the approved implant plan work under real fabrication and clinical conditions.
That may involve support, seating, insertion path, surgical access, sleeve or guide-hole geometry, fixation, material distribution, and compatibility with the selected implant system and guided kit.
These variables often interact. Improving one part of the design may create a new constraint elsewhere.
The buyer therefore does not need an external team that only knows how to place sleeves and export an STL. The more important capability is knowing:
- which design variables matter in the case;
- which conditions can be handled under an agreed standard;
- which exceptions require judgment;
- and when the approved plan or clinical team needs to be consulted before design continues.
That is the design capability being purchased.
Choose the Right Surgical Guide Outsourcing Scope
Surgical guide outsourcing does not have to mean transferring the entire workflow.
Planning, design, approval, fabrication, and clinical execution can remain with different owners depending on what capability already exists internally and what support is actually needed.
Common outsourcing scopes include:
- Implant planning only — an external team prepares the digital treatment plan for clinical review and approval.
- Planning + surgical guide design — the external team supports both planning and guide design, with clinical approval remaining with the responsible clinician.
- Design-only — the implant plan is already approved and the external team converts it into the required surgical guide design.
- Planning + design + final STL — the external team completes the digital stages and returns a fabrication-ready file so the receiving clinic or laboratory can fabricate locally.
- Planning + design + fabrication — the external provider continues beyond CAD into the agreed physical fabrication workflow.
These are not quality levels. They are different ways of allocating capability and responsibility.
A clinic with strong implant planning may need only design capacity. A dental laboratory with an established printing workflow may prefer design-to-STL support. Another organization may need both planning and design while retaining final clinical approval internally.
The outsourcing scope should therefore fill a defined capability or capacity gap, not automatically replace stages that are already working well.
Define the Scope Before the First Case
Terms such as “surgical guide outsourcing” or “planning and design service” can sound precise while still leaving important boundaries undefined.
Before the first case begins, five questions should be clear:
- Scope — Is the request planning, design, planning + design, design-to-STL, or a broader workflow?
- Input — What clinical, restorative, and system information is required for that responsibility?
- Responsibility — What should the external team review, prepare, flag, or revise?
- Deliverable — What digital or physical output will be returned?
- Next owner — Who controls clinical approval, fabrication, fit verification, or the next workflow step?
This becomes especially important in design-only and print-your-own-guide workflows.
A manufacturing-ready STL does not automatically mean the external design team owns resin selection, print orientation, post-processing, sleeve assembly, physical fit verification, or final clinical use.
Those downstream responsibilities should be explicit rather than assumed.
If the main question is still which stages should remain in-house and which are better outsourced, that is a separate make-or-buy decision. See Surgical Guide Workflow: Planning, Design, and Fabrication — In-House vs Outsourced for the deeper comparison of capability ownership, utilization, skilled capacity, operating burden, and hybrid models.
If the outsourcing boundary is unclear, Raytops can review one representative case and help determine whether planning, design-only, design-to-STL, or a broader planning + design workflow is the better fit before the process is scaled.
What Should an External Surgical Guide Team Review Before Work Proceeds?
An external surgical guide team should not begin by asking only whether the expected files have been uploaded.
The more important question is whether the submitted data, restorative context, implant system information, and guided surgery protocol provide enough reliable context for the agreed scope.
A case may contain CBCT/DICOM, an intraoral scan, STL files, implant information, and a restorative setup and still not be ready to proceed.
The issue may be the relationship between those inputs rather than the absence of one file.
Inputs Need Context, Not Just File Formats
Different inputs contribute different parts of the case context:
| Input |
What It Contributes |
What Must Be Clear |
| CBCT / DICOM |
3D anatomical context |
Image quality and usable anatomy |
| Intraoral scan / STL / PLY |
Teeth, soft tissue, restorative surface geometry |
Complete and usable surface data |
| Data alignment |
Relationship between volumetric and surface datasets |
Registration is reliable for the intended scope |
| Restorative setup / treatment plan |
Intended restorative objective |
Prosthetic intent is understandable |
| Implant system information |
Implant components and digital references |
Exact system is confirmed |
| Guided kit / sleeve data |
Physical guidance relationship |
Sleeve, drill, key, and protocol are compatible |
The required context should follow the outsourced responsibility.
A design-only case based on an already approved implant plan may require a different level of clinical interpretation from a planning + design case where the external team is expected to evaluate anatomy, restorative intent, implant positioning, and guide strategy together.
Review Should Distinguish Proceed, Clarify, and Hold
A useful review process separates three situations:
- Proceed — the submitted information is sufficiently complete and consistent for the agreed scope.
- Clarify — the case can proceed after one or more uncertainties are resolved.
- Hold — a critical issue could materially change planning, guide support, system compatibility, or transfer reliability.
Possible clarification or hold conditions may include questionable DICOM-to-surface alignment, incomplete scan coverage, unclear restorative intent, uncertainty about support strategy, missing implant system information, unfamiliar guided-kit requirements, or a conflict between the approved implant plan and the geometry required for the guide.
The purpose is not to create another communication loop around every minor imperfection.
A good external workflow should reduce management burden.
The more important skill is distinguishing between:
information that can safely be handled under an agreed protocol
and:
uncertainty that could materially change the result.
One rule is particularly useful:
Do not convert uncertainty into geometry.
Once an unconfirmed assumption has been built into a design, it can begin to look like an intentional technical decision.
Implant System and Guided Kit Compatibility Must Be Verified
“Supports major implant systems” is not enough information to evaluate an external provider.
Implant-system compatibility and guided-surgery compatibility are related, but they are not identical.
A digital implant library may allow an implant to be planned, while the physical guided workflow still depends on the relationship between:
- the planned implant position;
- the guided kit;
- sleeve or guide-hole geometry;
- drill or key protocol;
- available surgical access;
- and intended guidance level.
For a new or unfamiliar system, the relevant components and protocol should therefore be confirmed before the design is treated as fabrication-ready.
The stronger buyer question is not:
Does the provider know this implant brand?
It is:
How does the provider verify that the digital design corresponds to the physical guided system that will actually be used?
If a current case includes uncertain data alignment, a new implant system, or an unfamiliar guided kit, Raytops can review the available case data and system information before the uncertainty moves into planning or guide design.
How Should Approval, Revision, and Handoff Be Controlled?
Outsourcing adds capability, but it also creates additional handoff points.
The workflow therefore needs to preserve four things as the case moves between clinician, dental laboratory, external planning/design team, and fabrication:
- the approved intent;
- the current version;
- the decision owner;
- the next responsibility.
The file itself may remain technically intact while the context around it becomes less clear. That is why workflow control matters as much as file delivery.
Technical Review Is Not the Same as Clinical Approval
An external team can review a planning or design decision technically without becoming the final clinical decision-maker.
It may:
- identify incomplete data;
- flag conflicts;
- explain technical consequences;
- prepare alternatives;
- revise the plan or guide after feedback.
These are valuable responsibilities, but they are different from deciding whether the implant plan is clinically acceptable for the patient.
Whenever an issue changes implant planning or another clinical decision, the external team should make the problem and its consequences understandable and return the decision to the appropriate clinical owner.
Technical support should strengthen clinical decision-making, not make the approval boundary invisible.
Revisions Should Preserve the Approved Intent
A revision is not simply a CAD change.
One modification can affect another part of the workflow:
- changing implant position may alter sleeve geometry or access;
- changing support may influence seating or fixation;
- moving a sleeve may affect free drilling distance or guided-kit compatibility.
Revision control should therefore keep five things clear:
- what changed;
- why it changed;
- which version contains the change;
- whether another planning or design decision is affected;
- which version has been approved.
Not every adjustment requires renewed clinical discussion. The important distinction is whether the revision merely executes an already approved decision or changes the approved plan, guide strategy, compatibility, or another factor that requires new confirmation.
Design-to-Fabrication Handoff Needs More Than a Final STL
A manufacturing-ready STL defines the digital deliverable.
It does not automatically define everything that happens after delivery.
Depending on the workflow, downstream responsibility may include:
- 3D printing;
- material selection;
- print orientation and support strategy;
- post-processing and curing;
- physical inspection;
- sleeve insertion or assembly;
- final fit verification;
- preparation before clinical use.
Some of these may belong to the external provider; others may remain with the receiving clinic or laboratory.
The important point is that they should not remain undefined.
A complete handoff should therefore communicate:
| Handoff Element |
What It Means |
| Deliverable |
What digital or physical output is being transferred |
| Approval status |
Which planning/design version has been approved |
| Relevant context |
Which non-standard decisions or exceptions matter downstream |
| Next owner |
Who takes responsibility for the next stage |
| Remaining checks |
What still has to be verified |
For routine cases, the approved file and workflow status may be enough.
For non-standard cases, additional context may need to follow the file—for example an unusual support strategy, sleeve position, fabrication condition, or unresolved downstream check.
The goal is not more documentation.
It is to preserve only the information that can materially affect the next stage.
How to Evaluate a Surgical Guide Planning and Design Outsourcing Partner
Evaluating a provider should go beyond software, price, turnaround time, or whether the final STL looks clean.
Those factors matter, but they do not show how the team behaves when:
- submitted data are inconsistent;
- restorative intent is unclear;
- a guided kit is unfamiliar;
- a case does not fit the default design protocol;
- a revision changes more than expected;
- or responsibility becomes unclear at handoff.
A stronger evaluation asks whether the external team can enter the workflow without weakening the connection between planning intent, design execution, approval, and fabrication.
A practical framework is:
| Evaluation Area |
What Should Be Clear |
| Scope |
Where external responsibility begins and ends |
| Input |
What information is required |
| Review |
What is checked before work proceeds |
| Judgment |
What happens when the standard approach does not fit |
| Approval |
Which decisions require clinician confirmation |
| Deliverable |
What is actually returned |
| Handoff |
Who owns the next workflow stage |
| Evidence |
What demonstrates that the process works as described |
This also makes price comparison more meaningful.
Two quotations may appear similar while including very different levels of review, judgment, revision support, or handoff responsibility.
Ask for Workflow Evidence, Not Just Marketing Claims
Claims such as:
- experienced designers;
- high accuracy;
- strict quality control;
- support for major implant systems;
are easy to state because they describe conclusions.
The stronger question is:
What evidence inside the workflow makes those claims believable?
Useful evidence may include:
- examples of case-review comments;
- clarification requests made before planning or design proceeds;
- screenshots of planning or guide-design decisions;
- revision history;
- clinician approval workflow;
- guided-kit or system compatibility checks;
- sample fabrication-ready deliverables;
- design-to-fabrication handoff instructions;
- case examples showing how a non-standard problem was identified and resolved.
The goal is not excessive documentation.
It is to determine whether the claimed capability leaves observable evidence in the workflow.
A Trial Case Should Test the Workflow, Not Just the Final STL
A trial case is one of the most practical ways to evaluate an outsourcing partner.
But the STL should be treated as the output of the workflow, not the only thing being tested.
A useful trial should answer:
- Was the outsourcing scope understood correctly?
- Were the submitted data and case context actually reviewed?
- Were meaningful uncertainties identified before they became part of the design?
- Was design judgment visible when the standard approach did not fit?
- Were revisions implemented without silently changing approved decisions?
- Was clinical approval status clear?
- Was the fabrication handoff complete?
A strong trial therefore tests more than CAD ability.
It tests whether the provider can maintain:
scope clarity → review discipline → judgment → approval control → revision control → handoff continuity
from submission to delivery.
Evaluate Whether Management Burden Falls as Volume Grows
One successful case proves that a provider can complete one case.
Long-term outsourcing requires something more.
If every new case requires the same instructions to be repeated, every routine decision needs manual confirmation, or internal staff must repeatedly correct avoidable problems before fabrication, the external team may add capacity without reducing management burden.
A scalable relationship should make routine work more predictable over time.
Standard preferences, approved protocols, system requirements, guide conventions, revision rules, and handoff expectations can gradually become part of the working process.
The goal is not to eliminate communication.
It is to move communication away from routine repetition and toward the exceptions where judgment is actually needed.
That is especially important for laboratories, clinics, digital labs, and design centers using outsourcing as an ongoing capability rather than occasional case-by-case support.
Conclusion: Outsource a Defined Capability, Not an Undefined Responsibility
Surgical guide planning and design outsourcing works best when the external role is clearly defined inside the existing implant workflow.
The provider does not need to own every step.
It does need to understand:
- where its responsibility begins;
- what context it needs;
- what it should review;
- which decisions must return to the clinician;
- what constitutes the approved deliverable;
- and where responsibility moves next.
The final decision rule is simple:
Outsource a defined surgical guide capability, not an undefined responsibility.
A representative trial case is usually the most practical way to test whether that boundary works in reality.
Raytops can start with one representative case to review the required scope, submitted data, implant system, guided workflow, approval path, and fabrication handoff before a larger outsourcing process is established.
